JFK New Terminal One

New York, NY

As part of the landmark redevelopment of John F. Kennedy International Airport, the New Terminal One (NTO) stands as a transformative infrastructure project and the largest airport terminal in the nation. Envisioned as an international gateway providing an integrated, passenger-centric experience, NTO celebrates both the global character of New York City and the cultural diversity of Queens. Its 2.6 million square feet and 23 gates position it as a modern hub for air travel, built with a strong emphasis on sustainability and inclusivity, including the engagement of minority- and women-owned businesses.

Banker Steel and NYC Constructors (NYCC) played a key role by delivering the structural steel for this ambitious project, fabricating and erecting 33,000 tons of steel in the first phase. Their involvement was critical to meeting project milestones under complex logistical and engineering constraints. The success of their work was underpinned by the early adoption of a connected construction model—an essential strategy that helped mitigate schedule risks and drive coordination across teams.

The project’s critical path began with one of its most technically demanding tasks: erecting steel around the active AirTrain system. With AirTrain service permitted a maximum disruption window of only four months, Banker Steel and NYCC helped engineer and execute a 60-foot-wide by 900-foot-long steel structure with precast envelope to maintain transit operations while construction advanced overhead. This early-phase achievement set the tone for the precision and planning required throughout the build.

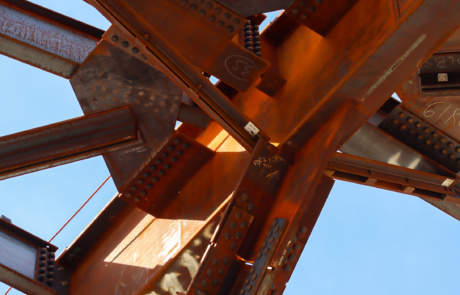

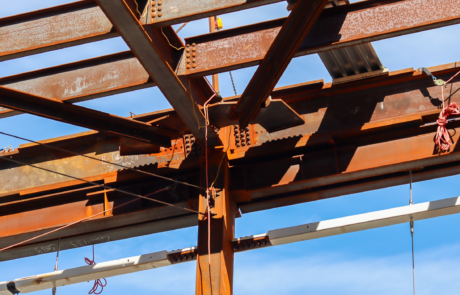

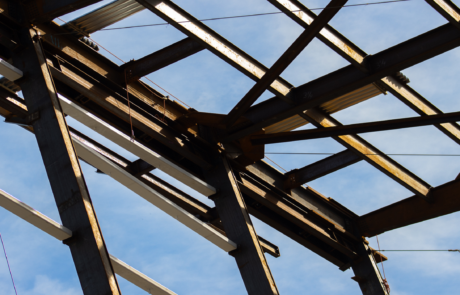

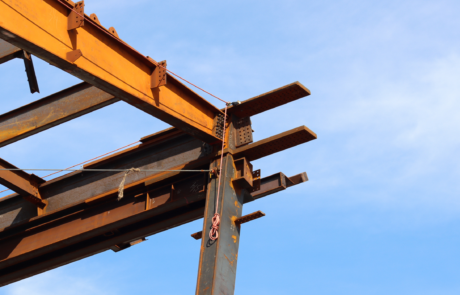

At the heart of the terminal is the Headhouse, an architectural and structural centerpiece supported by ten Y-shaped tree columns and sixteen additional branched columns. Each Y-column features a steel quasi-diamond-shaped forged node weighing 85,000 pounds, from which four sloped “branches” extend to support the sloped roof. Erecting these massive elements demanded advanced shoring solutions—met with an in-house system using 40 telescopic towers to stabilize and position the steel accurately.

Working in an active airport environment added a layer of complexity that required exceptional coordination. Crane operations were carefully designed to ensure compliance with FAA and Port Authority guidelines, while maintaining sightlines for the Air Traffic Control Tower. These restrictions demanded precise planning, adaptive sequencing, and responsive execution—all delivered effectively through the collaboration between Banker Steel, NYCC, Thornton Tomasetti, and the broader project team.

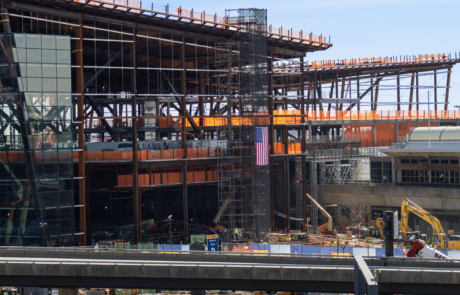

The team’s contributions culminated in the topping out of the Headhouse in March 2024 and the East Pier in August 2024—major milestones that reflect the strength of the partnership, the sophistication of the steelwork, and the high standards of safety and scheduling maintained throughout the project.

PROJECT OWNER

Ferrovial, Carlyle, JLC Infrastructure and Ullico

CONSTRUCTION MANAGER

AECOM Tishman

STRUCTURAL ENGINEER

Thornton Tomasetti

ARCHITECT

Gensler

STEEL TONNAGE

33,000
